Project and Portfolio Management
Version 26 39.5.25 39.5.23 39.5.22 39.5.21 39.5.20 39.5.19 39.5.18 39.5.17 German English
Version 26 39.5.25 39.5.23 39.5.22 39.5.21 39.5.20 39.5.19 39.5.18 39.5.17 German English

Subprojects MOD009A4F

Access

Information

  • In this module, a project structure is created in which the current project is divided into main and subprojects.

Details

  • The project structure is created and displayed graphically.

  • Each element (main project, subproject) is displayed in an individual box.

    • No tasks are displayed.

  • Every box contains the most important project parameters.

  • Every parent element contains a so called node field where the number of child elements is specified.

      • When creating new child elements, the number in the node field of the parent element is automatically refreshed.

    Module variants

    Base

    Contains the header data of a project and the project end dates. This variant is loaded first by default.

    Minimum

    Only contains the header data of a project

    Create and Assign New Subproject

    Procedure

    • Click on the Create subproject button in the box of the project to which you want to subordinate a project, or right-click and select the command of the same name from the context menu.

    • The What do you want to do? dialog message is displayed. Click on the Create new subproject button.

    • A new project is created and subordinated to the required project at the same time.

    • Click on the calculation button calculate_schedule.png in the toolbar. As a result, the entire project structure is recalculated and the newly created subproject is also displayed in the Schedule module.

    Details

    • Each new subproject in a project structure automatically inherits the values of some project parameters (upon creation) from its immediate parent project and the stakeholder from the main project of the project structure.

    ID generation in subprojects

    • The functional project ID is based on the main project ID, i.e. if the main project ID is 002034, a subproject ID on level 1 will be 002034.1, on level 2 it will be 002034.1.1 etc.

    • The technical IDs for subprojects, however, are incremented, in this case for a subproject on level 1: 002035, for a subproject on level 2: 002036, etc.,

    • The maximum length for a functional ID is 12. If this length is exceeded due to a high number of subproject levels, the functional ID is copied from the technical ID for a new subproject. In this case, the functional ID 002034.1.1.1 equates to the technical ID 002037. The next technical ID is 002038 (provided that the number chain is not interrupted by the creation of further projects, e.g. by another user) and is copied to the functional ID. This is indicated by a message.

    Technical Background Information

    • After subprojects have been created and the project has been calculated, a structure task for the respective child project will be created automatically in each parent project.

      • Structure tasks are links between parent and child projects.

      • In the standard program, structure tasks are not displayed and cannot be displayed by the user. For further information, see here.

    Note

    Assign Existing Project as a Subproject

    Information

    • Already existing projects can be assigned to other projects as subprojects.

    Procedure

    • Click on the Create subproject button in the box of the project to which you want to subordinate another project, or right-click and select the command of the same name from the context menu.

    • The What do you want to do? dialog message is displayed. Click on the Assign existing project button.

      • The Include subproject into the structure module is opened.

      • Select the required project(s) from the displayed project list by activating the Select checkbox.

        • The projects offered for selection here are active (Status=1), unstructured projects with posting type=0, which are not assigned to any program or portfolio and have no status reports.

      • Click on the Assign subprojects button.

      • Answer the query to the parent project on the ID adjustment of the project to be assigned.

    • The selected project will automatically be assigned to the main or subproject.

    Stop

    • Due to the settings in the standard, only subprojects without status reports can be selected when subordinating existing projects. Manipulating this setting may lead to data corruption in status reports!

    • When subordinating an existing project to another project, the project to be subordinate must not be open. If it is open and you try to subordinate it, a message is displayed, indicating that the project is to be closed.

    Remove Subproject from the Structure

    Information

    • Subprojects can be removed or detached from the project structure.

      • If a subproject is removed from the structure, it will be retained as an independent project.

    Procedure

    • Click on the Remove subproject from the structure button in the box of the subproject to be removed from the structure or select the context menu command of the same name.

    • Confirm the Do you really want to remove the subproject from the structure? message with Yes.

    Note

    • If the subproject to be deleted from the structure has subprojects itself, they are removed from the structure along with the subproject to be deleted.

    • If the subproject to be removed from the structure has external links to other subprojects or to the main project, a prompt is displayed, asking whether it is to be deleted or not.

    Change Existing Project Structure

    Information

    • The existing project structure can be changed by moving the project box in the Subprojects module. To do so,

      • click on the box of the required subproject and drag it to the required position and release the mouse button.

      • Save.

      • The structure is updated.

    Stop

    • Projects which contain status reports may not be subordinated to a project that already contains status reports. Disregarding this rule may result in incorrect data in status reports and thus leads to incorrect evaluations.

    Change Functional ID of Subprojects

    Information

    • PLANTA project distinguishes between

      functional ID

      and

      technical ID

      .

      • They are both generated automatically when a project, proposal, idea, or program is created and are equal at that point.

      • The functional ID is visible in various modules and can be changed if required for certain reasons.

      • The technical ID must not be changed. It is not visible in the module and remains unchanged even if the functional ID is changed.

    Change functional ID

    • In the header bar area (in the Subprojects module in the box of the required subproject), click on the button with a pen on the right hand side.

    • The Do you really want to change the functional ID system wide? dialog message will be displayed.

    • Confirm it with Yes.

    • A dialog window containing an input field is opened.

      • The functional ID needs to be defined uniquely in the system. If you enter an already existing ID and click outside the field, the The required object ID is already used message will be displayed and the value will be reset.

      • Enter the new ID here.

    The ID will be changed throughout the system by default (global Change functional ID globally project parameter is activated by default) hence e.g. also in already existing status reports.

    Note

    Open Project (Sub or Main Project)

    Procedure

    • Here, click on the link on the ID of the project in the respective project box.

      • The Project panel of the required project is opened.

      • According to the rights of the user, the project data can either be viewed or edited.

    Delete Subproject

    Information

    • It is not possible to delete subprojects directly from within the Subprojects module.

    In order to delete a subproject, you can proceed as follows:

    • 1. Either you remove the required subproject from the structure of the main project and then delete the removed project like an independent project.

    • 2.

      Or you delete a subproject from within the main project. To do so,

      • click on the delete button in the Project Core Data of the main project.

      • The Delete module is opened.

        • Click on the Delete button next to the required subproject.
        • Confirm the Do you really want to delete this planning object? dialog message with Yes .
        • A subproject can only be deleted if it has no subprojects.
          • If a subproject contains further child projects, a dialog message will be displayed when deleting this subproject: Deletion not possible: there is a (are) subordinate project(s).
          • If you want to delete a subproject and its child projects, you have to delete all of its child projects beforehand.

    Rights to delete

    are granted to users with multi-project manager or multi-portfolio manager or multi-project/request manager rights.

    • If the user does not possess any of these rights, no delete button will be displayed in the Project Core Data module and the Delete module can thus not be opened.
    • If the project to be deleted already has actual postings (recorded hours worked, posted costs or revenues) the deleting user requires an authorization to delete postings in addition to the rights mentioned above. If the user does not possess either of these authorizations, a message will be displayed in the Project Core Data when the delete button is clicked on, which indicates that the user is not entitled to delete actual postings and the Delete module will not be opened.

    Technical Background Information on the Structuring Process

    Information

    • After projects have been structured and the schedule has been calculated, a structure task will be created automatically in each parent project. The structure task is a task which links a parent project to a subproject.

      • In the Standard, structure tasks are hidden in all modules in question by default and cannot be displayed by the user. This is to be considered for individual customizing as well.

      • The Structure task parameter defines whether a task is a normal or a structure task.

        • The Structure task parameter defines whether a task is a normal or a structure task.

    • When structuring the projects, for all child projects, the following parameters will be set:

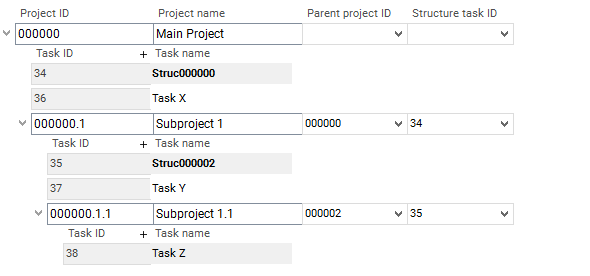

    • Below you will find a model structure which shows what happens in the background when projects are structured (structure tasks, the 2 fields mentioned above are filled):
