If you have changed the copy type while copying, you can change to the Field to Field type again using the Edit → Drag&Drop copy →Field to field menu item or via shortcut CTRL + 1.
You cannot only copy field content between records within a module but also between two modules.
Task 1.1 is to be outdented (it is no longer to be a child of task 1).
You can outdent the task by moving the child record above or below the required parent record. A parent record can be the parent record of the required child record or every other parent record, depending on the position to which the child record is to be moved.
The task is placed at the position to which it is moved with the mouse.

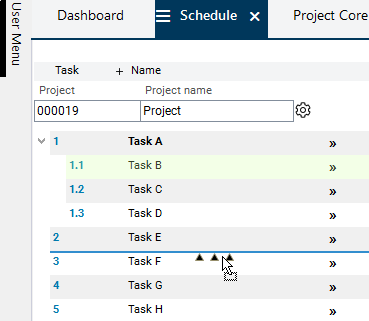

By pressing SHIFT and holding the left mouse button, drag task 1.1 above task 3 so that a dark blue line appears above task 3.
Release the left mouse button.

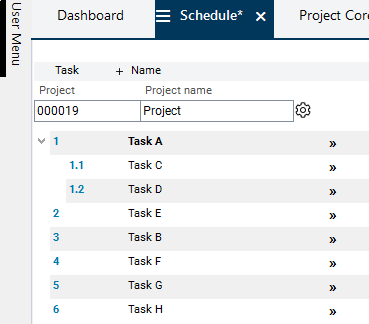

Result: Task 1.1 is positioned on the highest level above task 3. Thus, it is no longer a child of task 1.

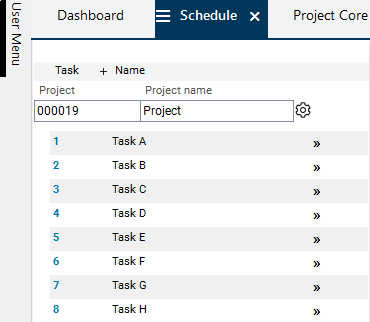

Click on the Generate WBS code button next to the project name.
Result: The new structure is displayed.
Moving without Structuring
Task 1.2 is to be positioned above task 1.1.

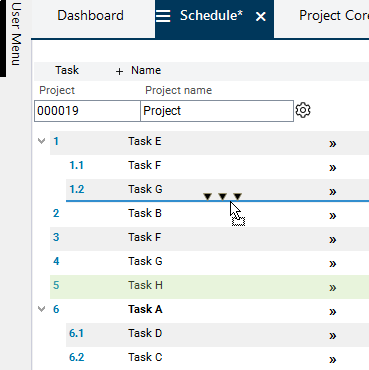

By pressing SHIFT and holding the left mouse button, drag task 1.2 above task 1.1 so that a dark blue line appears above task 1.1.
Release the left mouse button.
Result:

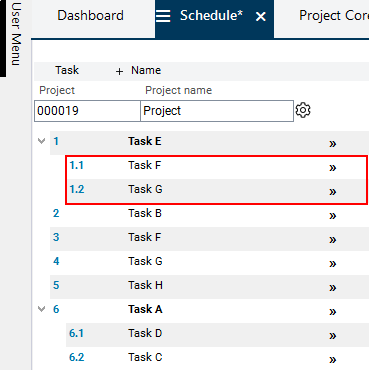

Summary task 1 and its children are to be positioned below task 6

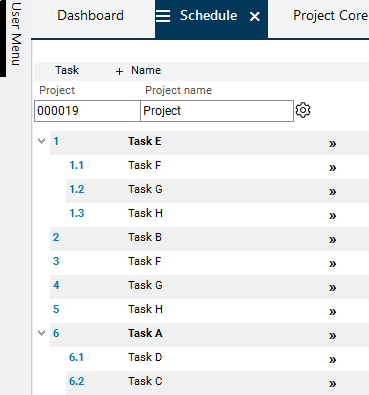

By pressing SHIFT and holding the left mouse button, drag task 1 below task 6 so that a dark blue line appears below task 6.
Release the left mouse button.

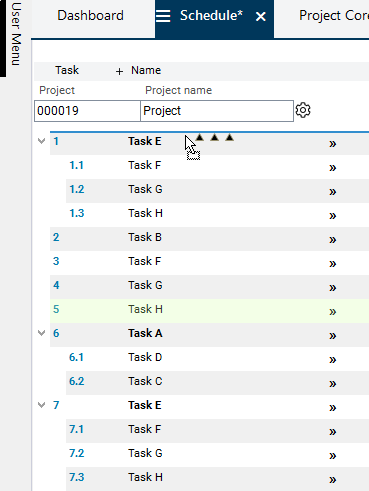

Result:
Save and click on the Generate WBS code button below the project bar.
Result: The new structure is displayed.
Copy
Notes
When records are copied, the IDs of the target objects will be newly created.
Other IDs in the target object may be adjusted too.
Values of the output fields are not included when copying.
Values of the source object input fields, also those of hidden input fields, will not be included when copying.
Only visible records will be copied. I.e. if you copy a record that has some of its child records hidden in the module via filter criteria, only the visible child records will be included.
Structure by copying
Information
In order to copy entire records, the following setting must be made:
Select Edit → Drag&Drop copy → Record/s in the menu bar or use the CTRL + 4 shortcut.

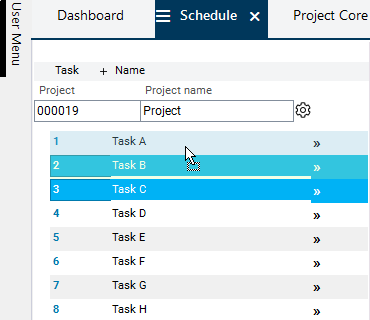

Copies of tasks 3 and 4 are to be created and to be subordinated to task 1 at the same time

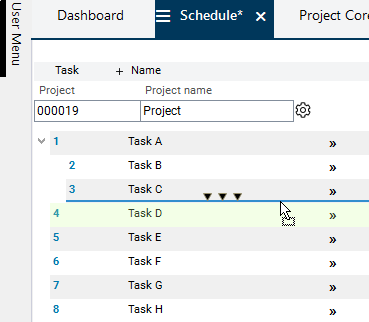

Mark tasks 3 and 4 and drag them to task 1 by pressing STRG + holding down the left mouse button.
Release the left mouse button.
Save and click on the Generate WBS code button.
Result: Tasks 1.1 and 1.2 have been created automatically with data from tasks 3 and 4 and have been assigned to task 1.
Furthermore a copy of task 5 is to be created and to be subordinated to task 1 as well.
Drag task 5 below task 1.2 by pressing CTRL and holding down the left mouse button.
Release the left mouse button.
Save and click on the Generate WBS code button.

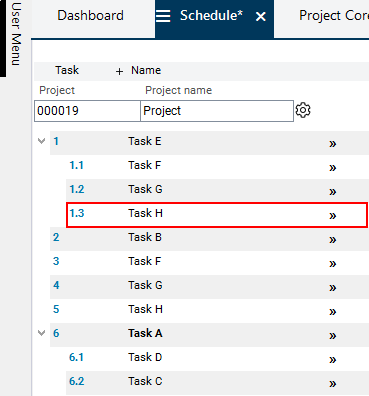

Result: Task 1.3 has been created automatically with data from task 5 and has been positioned below task 1.2.
Save and click on the Calculate schedule button in the toolbar.
Result: Parent task 5 is displayed in bold.
Copying without Structuring
Information
In order to copy entire records, the following setting must be made:
Select Edit → Drag&Drop copy → Record/s in the menu bar or use the CTRL + 4 shortcut.
A copy of summary task 1 should be created and positioned below task 6 too.
By pressing CTRL and holding the left mouse button, drag task 1 below task 6 so that a dark blue line appears below task 6.
Release the left mouse button. If CTRL is released too soon, the record will not be not copied.
Save and click on the Generate WBS code button.

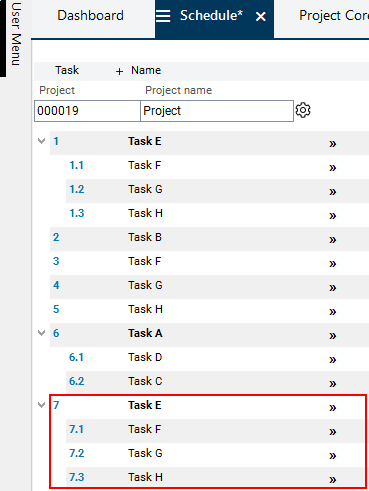

Result: Task 7 is created with the data from task 1 and positioned below task 6.
A copy of task 5 should be created and positioned below task 1 as well.
Drag task 5 above task 1 while pressing CTRL and holding down the left mouse button, so that a dark blue line appears above task 1.
Release the left mouse button.
Result: A new task has been created with the data from task 5 and has been positioned above task 1.
Save and click on the Generate WBS code button.

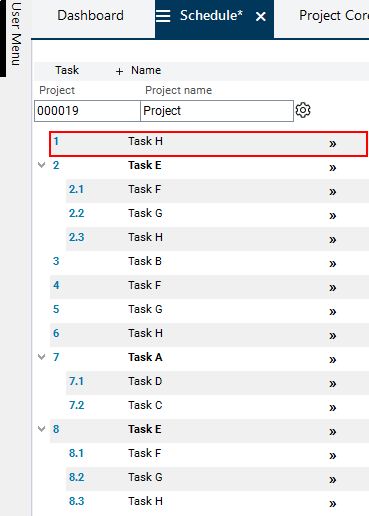

Result: Due to its top position, the new task becomes task 1.
JavaScript errors detected
Please note, these errors can depend on your browser setup.
If this problem persists, please contact our support.
