Calculation of the Dates
General
The results of scheduling include:
earliest start-/end dates, latest start-/end dates and calculated start-/end dates on project level
earliest start-/end dates, latest start-/end dates and calculated start-/end dates on task level
and, if resources are already planned, calculated start/ end dates of the assigned resources as well as their loading and capacity adjustment.
Calculation of Start Dates
Information
The network theory and the practical approach are available for determining the start of a task successor.
Network plan theoretical approach | Practical approach ![]() |
in PLANTA project
tasks with duration > 0 and EA relation are planned according to the practical approach, i.e. The successor starts on the following working day
tasks with duration = 0 (e.g. milestones) and EA relation are planned in the following way:
If the duration of a task = 0, you can define via the Successor task start +1 day model parameter when its successor is supposed to start.
If the successor of a task has a duration of = 0, the successor always starts on the same day as the task itself.
Details
Requested and actual dates on non-working days (vacation, absence) remain valid and are taken into account during the calculation of the calculated dates. Start and end dates can thus also be scheduled on non-working days. However, the duration of a task is displayed in working days regardless. The resources are only loaded on working days.

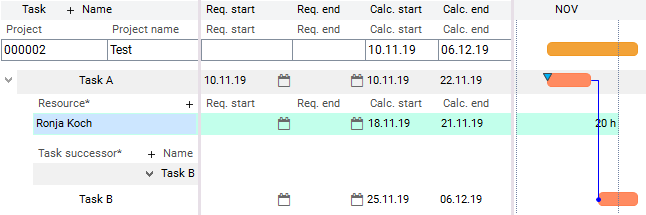

Example
The TA Requested start of task A falls on Sunday, 11/10/2019, a non-working day. The start of task A is scheduled for the Requested start date.
Task B has no requested date, it therefore starts on the next working day.
Resource Ronja Koch is on vacation from 11/11/2019 to 11/15/2019. It is not planned within the vacation period.
