Project and Portfolio Management
Version 27 Version 26 39.5.25 39.5.23 39.5.22 39.5.21 39.5.20 39.5.19 39.5.18 39.5.17 German English
Version 27 Version 26 39.5.25 39.5.23 39.5.22 39.5.21 39.5.20 39.5.19 39.5.18 39.5.17 German English

Tutorial: Hybrid Planning with PLANTA project and Jira

Introduction

Objective of this tutorial

  • To teach first time users how PLANTA project and Jira can be used together to combine traditional and agile project management.

Please note:

  • All exercises are based on the PLANTA demo data. This data must be installed beforehand.

  • Before you start with the Jira tutorial, your PLANTA administrator has to set up a Jira system and

    connect it to PLANTA project

    .

    • Please ask the administrator for the user and login data of the Jira system.

  • The screenshots used in this tutorial are mere examples of functions and their layout may deviate from the actual layout in the program.

PLANTA project Project Creation and Outline Planning

Create Project and Assign Resources

Task

  • Multi-project manager Georg Hart wants to plan a new IT project using PLANTA project and Jira.

  • To do so, he first creates a project in PLANTA project and carries out the resource assignment.

Procedure

  • Open the PLANTA project client. Log in with user "r41" for Georg Hart.

  • Click on the New project button or select Multi-Project Management → Project Planning → New Project in the user menu.

    • The Project panel is opened with activated Project Core Data module.

    • Enter a project name (e.g. “IT Project Jira”).

    • Georg Hart is automatically entered in the Manager field. Do not change the entry, for he is to be the responsible project manager of the new project.

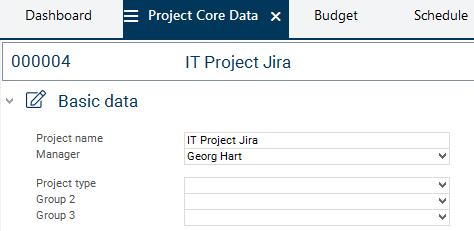

    • Save. Result:

  • Switch to the Schedule module.

  • Answer the Do you want to copy a schedule? query with Yes.

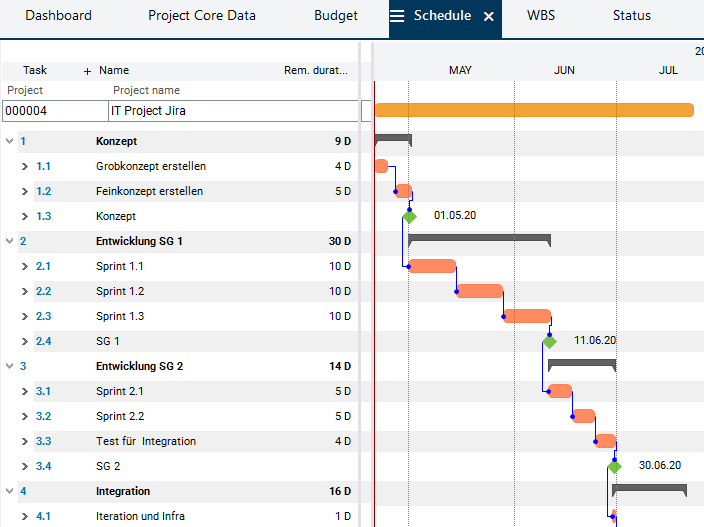

  • Select schedule template A1.1 Standardplan IT-Projekt mit Sprints ("Standard schedule IT project with sprints") from the listbox in the Copy Schedule module.

  • Click on the Copy schedule button.

  • Result:

  • Right-click on the Sprint 1.1 task to open the context menu and select the Assign resources entry.

    • The Assign Resources module is opened.

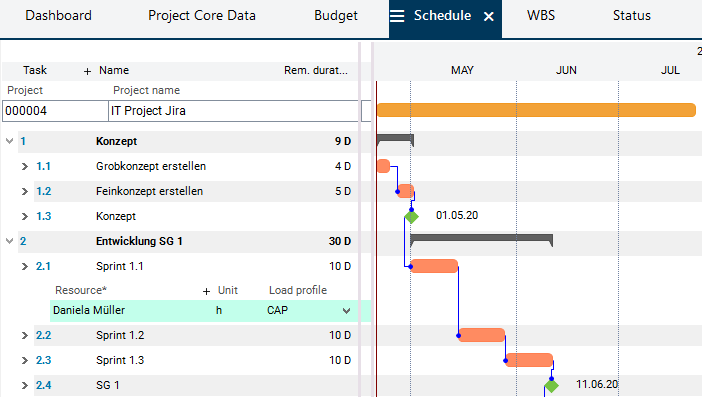

    • Activate the checkbox of the resource entry for Daniela Mueller.

    • Click on the Assign selected objects button.

  • Save.

  • The outline planning in PLANTA project is completed. Georg Hart now wants to link and synchronize the project and the Sprint 1.1 project task with Jira, so that he can begin with his in-depth planning.

Synchronize Project

Information

  • The project must have been approved for editing before it can be connected to an external system like Jira.

  • Furthermore, the functional project ID needs to comply with the Jira-ID format, i.e. the functional project ID must begin with a letter followed by one or more letters or numbers. A maximum of 10 characters is permitted. Special characters are not permitted.

Task

  • First, Georg Hart wants to change the functional project ID so that it complies with the Jira-ID format.

  • Subsequently Georg Hart wants to approve the IT Project Jira project for editing and synchronize the project with the external system Jira.

Procedure

  • In the Project Core Data of IT Project Jira, click on the FachIDAendern.png Change functional ID button in the header area.

  • Confirm the Do you really want to change the functional ID system wide? query with Yes.

  • Enter a new functional ID (e.g. IT01).

  • Save. The functional ID now complies with the Jira-ID format.

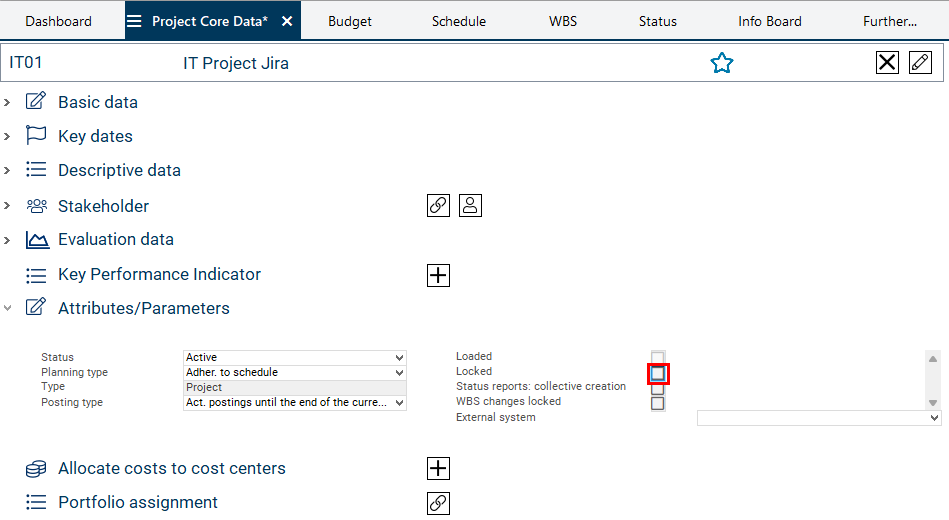

  • Deactivate the Locked checkbox in the Attributes/Parameters area.

  • Save. The project is now approved for editing.

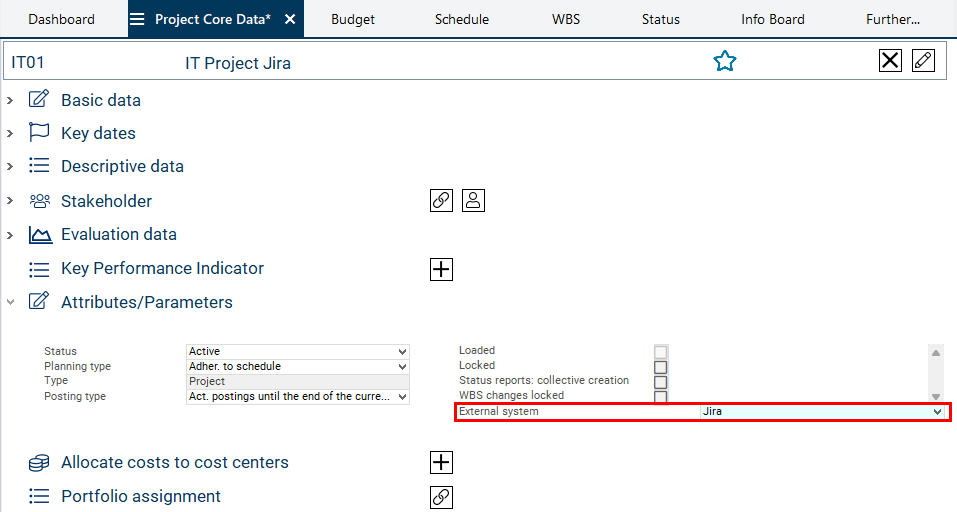

  • Select the "Jira Server" entry from the External system listbox.

  • Save. Jira has now been assigned to the project as an external system and the project is synchronized with the Jira system, i.e. the very same project has now been created in Jira.

Synchronize Project Task

Task

  • The outline planning in PLANTA project has been completed and the IT Project Jira project is already synchronized with Jira. Georg Hart now wants to link and synchronize the Sprint 1.1 project task with Jira, so that he can begin with his agile planning.

Procedure

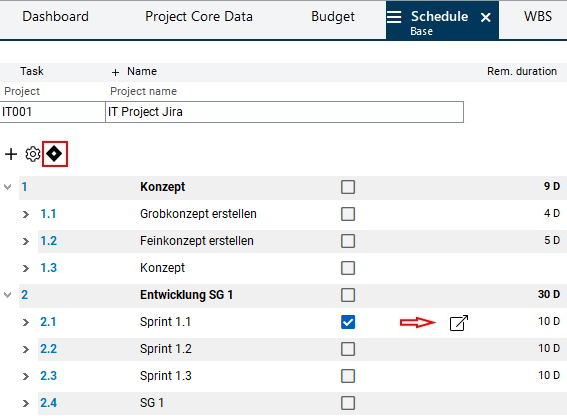

  • Open the Schedule module and click on the Jira symbol in the button area. As a result, the Jira column with the checkboxes for selecting the tasks is now activated for synchronization.

  • Activate the checkbox for the Sprint 1.1 task and save. This triggers the synchronization of the task with Jira.

  • Next to the activated checkbox, an app-switch-symbol is displayed via which you can switch to the Jira system.

Note

  • All further changes made to this task are also automatically transmitted to Jira after saving. The opposite is true as well: if data which is relevant for the project system is changed in Jira, it is automatically synchronized with PLANTA project.

Jira: Complete Tasks and Record Hours Worked

Task

  • Georg Hart now wants to check the synchronization results and subsequently view the data in Jira.

  • To do so, he clicks on the ButtonJiraAufrufenEN.png symbol in the line of the Sprint 1.1 task in the Schedule and switches to the Jira system.

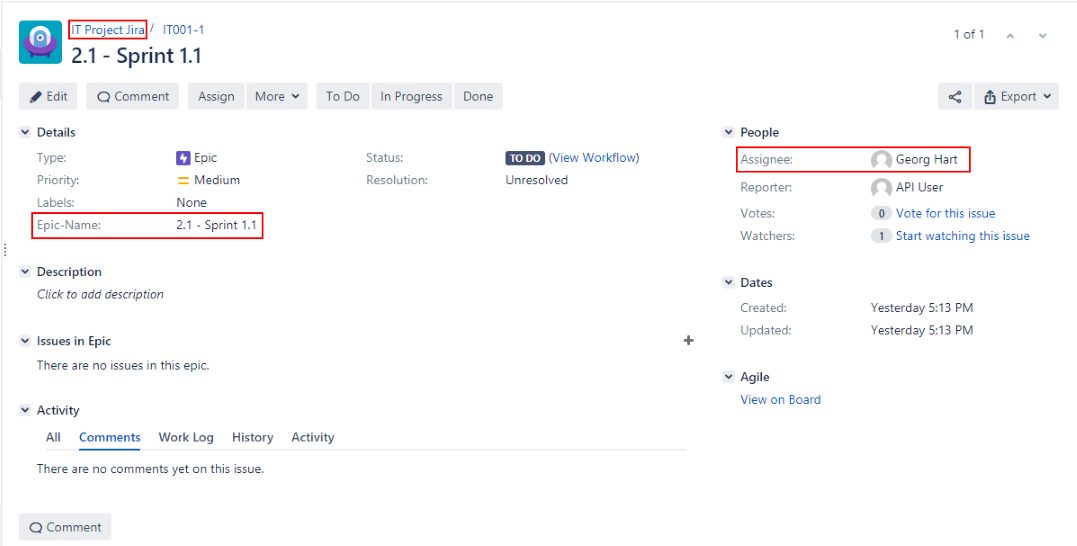

    • If Georg Hart is not logged in to Jira yet, the No issues were found to match your search message will be displayed. After successful login, the newly created epic is displayed.

Details

  • The following data has been transferred from PLANTA project to Jira:

    • Project : A corresponding project was created in Jira.

    • Task : The synchronized task has become an epic in Jira.

    • Project manager: The project manager (here: Georg Hart) from PLANTA project has become the assignee of the epic in Jira.

Task

  • Georg Hart wants to split up the epic into smaller tasks, "called "stories in Jira, and assign these to the people corresponding to the task resources in PLANTA project.

Procedure

  • He creates a story (e.g. Development Feature 1) and assigns it to Daniela Mueller.

  • If Daniela Mueller now logs in, she can see the story and start working on it.

Task

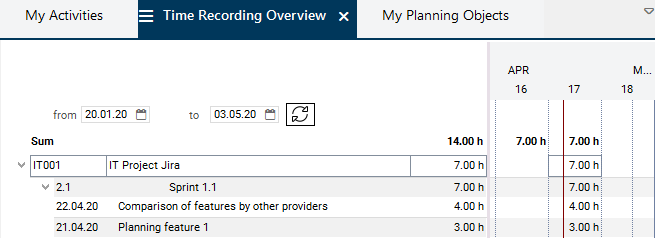

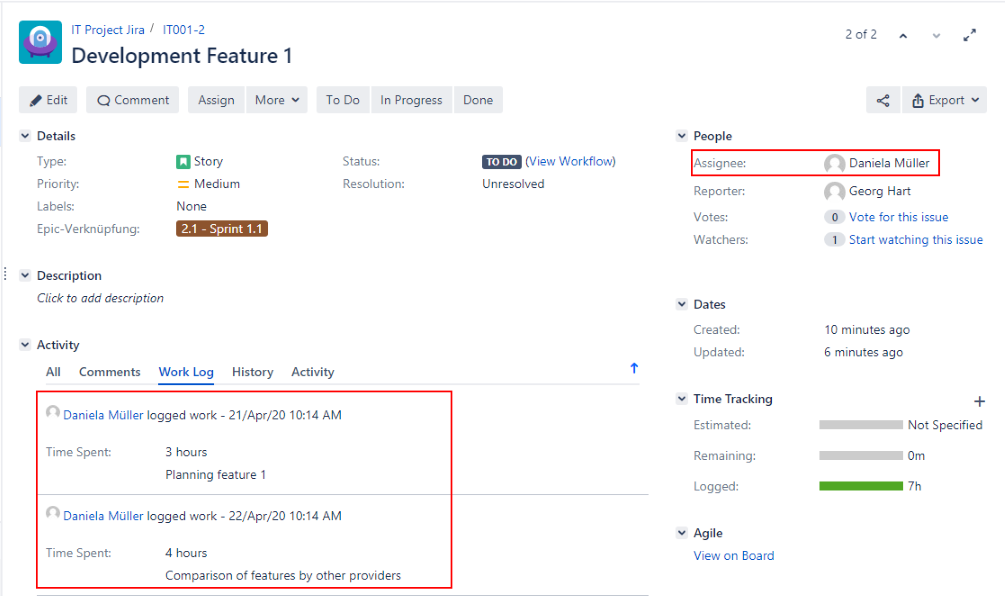

  • After Daniela Mueller has worked on the story for several hours, she records them in Jira and adds comments to her records:

  • When saving, the hours are automatically sent to PLANTA project so that the project manager can always see the current data.

PLANTA project Monitor Progress

Task

  • Manager Georg Hart wants to look at the hours worked recorded by the project team in PLANTA project in order to be able to estimate the work progress of the Sprint 1.1 project task.

Procedure

  • Go to PLANTA project.

  • Open the Schedule module of the IT Project Jira project and click on the calculate_schedule.png Calculate schedule button.

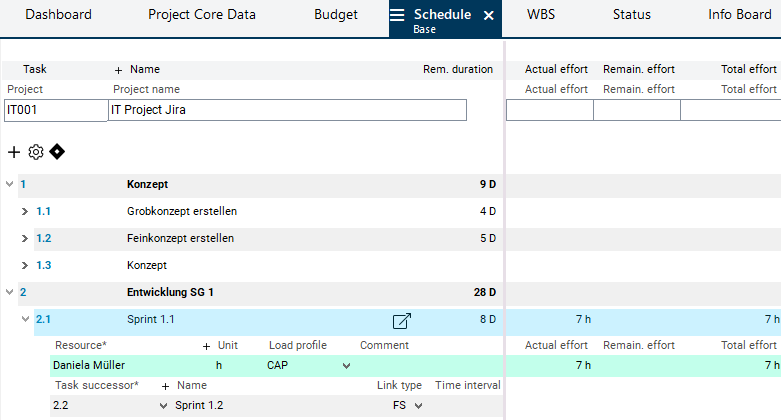

  • The 7 hours which Daniela Mueller has recorded in Jira are now displayed in PLANTA project.

  • To view details on the recorded hours, i.e. the exact loads

    • either open the module variant With Loads of the Schedule module

    • or open the Progress module (via Further... ).

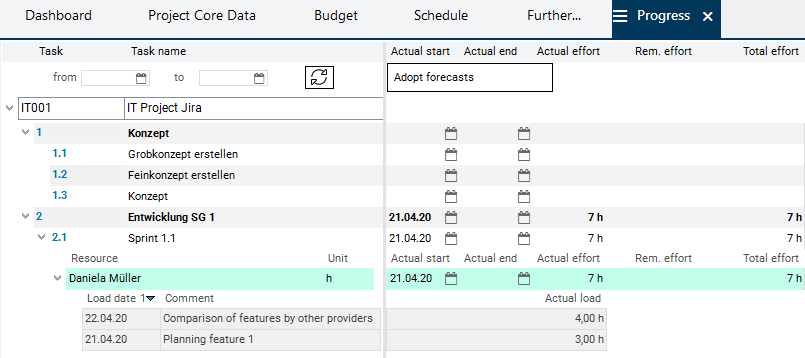

  • Unfold the Sprint 1.1 task record and Daniela Mueller’s resource record.

    • The individual work loads recorded by Daniela Mueller in Jira are displayed.

Note
